Loading

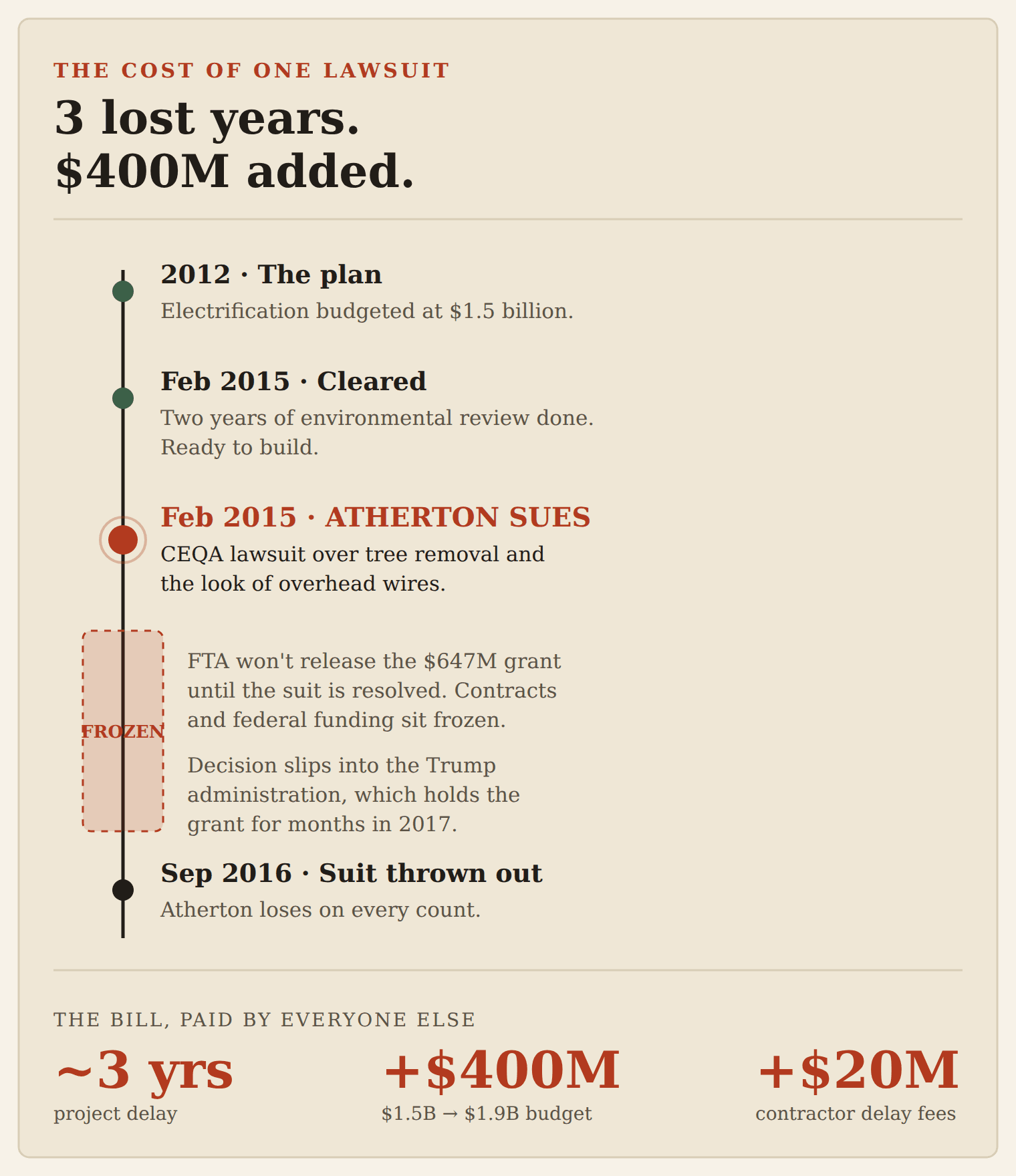

Atherton spent ~$145K to delay Caltrain electrification. The rest of us paid $400 million and waited 3 extra years — Peninsula for Everyone · YIMBY Action
